Your maintenance team can work around missing tools. They'll borrow from another shop, make do, maybe buy their own. But when your asset data is a mess — duplicate records, conflicting serial numbers, ghost assets that exist in the system but not in reality — the entire operation starts bleeding money in ways you won't catch until the auditors arrive.
One chemical plant found 1,400 duplicate asset records during a system cleanup. The maintenance team had been doing triple the PMs on critical equipment while other assets went completely unmaintained. Their CMMS showed 98% PM compliance. Actual equipment coverage was closer to 60%.
The problem isn't just extra work. Bad asset data corrupts every downstream decision. Reliability calculations become meaningless when the same failure gets logged under multiple IDs. Capital planning turns into guesswork when you can't trust asset age or replacement costs. Insurance claims get rejected because asset values don't match between systems.
Most organizations treat asset data like it's somehow less important than financial data — but your asset records ARE financial records. Every pump, motor, and valve represents capital investment, depreciation schedules, maintenance budgets, and operational risk. A $50,000 compressor that exists in your EAM but not your fixed asset register isn't just a data problem. It's a compliance violation waiting to happen.
The real cost of ungoverned asset data
A food processing plant discovered their asset data problem during an insurance audit. The auditor randomly selected 50 assets from their CMMS for physical verification. Only 31 matched reality. The rest were duplicates, decommissioned equipment still showing as active, or assets that had been modified so extensively they no longer resembled their original specifications.
The insurance company flagged them as high-risk. Premiums jumped 40% at renewal. But that was just the start. They also found:
-
Maintenance costs inflated by roughly 22% due to duplicate PM schedules
-
$1.2 million in "ghost" spare parts inventory tied to decommissioned assets
-
Critical equipment running without coverage because it was logged under obsolete IDs
-
Three years of incorrect depreciation calculations requiring amended tax filings
The CFO asked the obvious question: "How did we let asset data get this bad when we have controls for every $500 purchase order?"
The answer is simple — nobody owns asset data the way someone owns financial data. There's no equivalent to a controller signing off on asset records. No month-end close process for equipment databases. No audit trails for when someone changes a criticality rating or modifies a nameplate value.
How duplicate assets multiply in your system
Duplicate asset records don't happen overnight. They accumulate through a thousand small decisions where the path of least resistance wins.
Stop losing track of critical assets.
Ownitly helps you monitor, maintain, and manage every asset efficiently and reliably.
- Centralized asset tracking
- Automated maintenance alerts
- Compliance monitoring & reporting
No credit card required
A technician can't find asset #4521-P-101A during a breakdown. Equipment is down, production is screaming, and searching through 10,000 records isn't happening right now. So they create a "temporary" record to log the work order. That temporary record becomes permanent. Now you have two.
Or consider what happens during capital projects. The project team creates assets in the ERP for procurement and capitalization. The maintenance team creates the same assets in the CMMS for PM scheduling. The automation team creates them again in their historian. Three systems, three different people, three different asset IDs for the same physical equipment.
Shift handovers: Night shift can't find the asset day shift mentioned. Instead of calling someone at 2 AM, they create a new record. "We'll clean it up later."
Contractor work: Outside contractors create their own asset records because they can't access or don't understand your naming conventions. These get imported wholesale into your system.
System migrations: Legacy data gets imported without deduplication. Every historical duplicate gets preserved in amber in your new system.
Organizational changes: Different sites use different standards. After a merger, you inherit multiple versions of the same equipment.
Emergency repairs: During critical breakdowns, technicians create quick placeholder records to keep work flowing. These rarely get reconciled afterward.
A single cooling tower can exist under seven different IDs across three systems, with each department convinced they own the "real" record. Maintenance history gets scattered across all of them, making root cause analysis essentially impossible.
Why traditional data cleanup fails
Most organizations try to fix asset data problems with what I'd call "big bang" cleanup projects. Hire consultants, dedicate resources, spend six months reconciling records, declare victory. Eighteen months later, the data is bad again.
These projects fail because they treat symptoms, not causes. It's like mopping up water without fixing the leak. You can deduplicate records all day, but if your processes still allow uncontrolled asset creation, you're just resetting the clock.
The typical cleanup project looks like this:
-
Export all asset data to Excel
-
Sort, filter, and identify duplicates
-
Manually review and merge records
-
Re-import clean data
-
Send an email asking everyone to "please maintain data quality going forward"
Six months later, duplicates are back. Because nothing changed in the actual workflow. The same technician facing the same breakdown pressure will make the same decision — create a duplicate rather than search for the correct record.
These cleanup projects can also make things worse before they get better. Merging records without proper rules loses critical maintenance history. Deleting what looks like a duplicate might remove the only record linking to your spare parts inventory. One manufacturer accidentally deleted $3 million in warranty entitlements because duplicate assets were purged without checking contract links.
The asset data governance framework that actually works
An asset data governance framework works when it treats asset records with the same rigor as financial records — not purely for compliance reasons, but because bad asset data destroys operational performance just as surely as bad financial data destroys fiscal performance.
Here's the framework structure that holds up across real implementations:
Asset Data Ownership Model
Asset Data Steward (Site Level)
-
Reports to
Site Manager or Reliability Manager
-
Accountable for
All asset records within their site/area
-
Authority to
Reject non-compliant asset creation requests
-
Measured on
Data quality metrics, duplicate rate, audit pass rate
Asset Class Owners (Technical Level)
-
Reports to
Engineering Manager
-
Accountable for
Technical standards for their asset class
-
Authority to
Define mandatory fields, naming conventions, criticality rules
-
Measured on
Standard compliance, cross-site consistency
Asset Lifecycle Controller (Financial Level)
-
Reports to
CFO or Controller
-
Accountable for
Asset financial data integrity
-
Authority to
Lock financial fields, require approval for value changes
-
Measured on
EAM-to-ERP reconciliation, audit readiness
This isn't about creating bureaucracy. It's about having someone who thinks about data quality the way a controller thinks about month-end close.
Lifecycle State Management
Every asset needs defined lifecycle states with clear transition rules. You can't just flip an asset from "operating" to "decommissioned" without triggering workflows.
The Seven Lifecycle States That Matter:
-
Planned — Asset approved but not yet procured
-
Staged — Asset received but not installed
-
Commissioned — Asset installed and tested
-
Operating — Asset in normal production
-
Standby — Asset available but not running
-
Decommissioned — Asset removed from service
-
Disposed — Asset physically removed from site
Each state transition requires approval from the appropriate role, mandatory data updates (like final meter readings), triggered workflows (like spare parts evaluation), and an audit trail with reasoning.
A paper mill implemented this model and saw duplicate creation drop by around 85% in six months. Technicians could now see that asset #234 was in "Standby" status, not missing from the system. They stopped creating duplicates for equipment that was temporarily offline.
Creation Gates and Controls
New asset creation should be harder than creating a purchase order — not bureaucratically harder, but systematically controlled to prevent duplicates at the source.

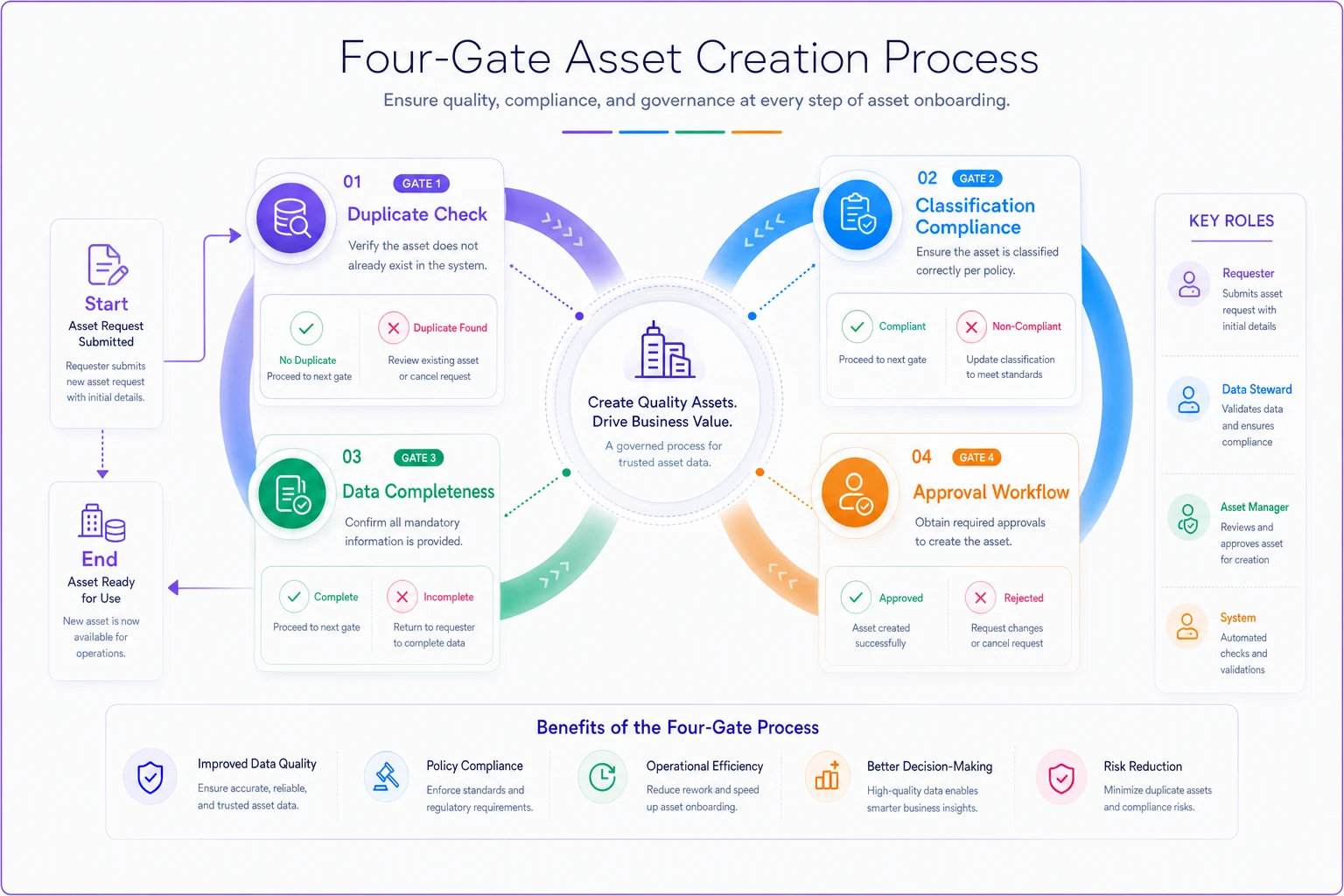

The Four-Gate Asset Creation Process:
Gate 1: Duplicate Check Before any asset creation, the system forces a duplicate check: search existing assets by serial number, by manufacturer and model, and by functional location. Potential matches display with photos. Only after confirming no matches can you proceed.
Gate 2: Classification Compliance The asset must be classified correctly — select from a controlled asset class list, inherit mandatory attributes for that class, apply standard naming conventions, and auto-generate the asset ID based on rules. No more free-text asset names like "Big pump by the blue tank."
Gate 3: Data Completeness Mandatory fields must be populated based on asset class. Critical assets need failure impact assessments. Rotating equipment needs nameplate data. Pressure vessels need certification dates. All assets need photos and location.
Gate 4: Approval Workflow Different asset classes require different approvals:
-
Production equipment requires sign-off from the Operations Manager
-
Safety equipment goes to the EHS Manager
-
High-value assets above $50K need Finance Manager approval
-
Every asset requires sign-off from the Area Data Steward
Surface duplicate-check results with photos on the asset creation screen to make decisions faster.
A simple workflow diagram helps explain the gate sequence.
This might seem like overkill, but one duplicate on a critical asset can trigger thousands of dollars in unnecessary maintenance, incorrect spare parts orders, and compliance issues. Five minutes of proper creation saves hours of cleanup.
Change Control Workflows
Once an asset exists, changes to critical fields need control. Not every field — that would gridlock operations — but the fields that matter for compliance, safety, and financial reporting.
Protected Fields Requiring Approval:
-
Asset classification
-
Criticality rating
-
Serial number
-
Acquisition value
-
Installation date
-
Warranty information
-
Parent/child relationships
The Change Request Workflow:
-
User requests change with justification
-
System shows impact analysis (linked work orders, PMs, parts)
-
Data Steward reviews for downstream effects
-
If approved, change executes with full audit trail
-
Affected departments get notified
-
Monthly report shows all critical changes
A pharmaceutical company implemented this after discovering someone had been changing asset criticality ratings to manipulate the maintenance schedule — downgrading assets from "GMP Critical" to "Normal" to avoid weekend PM work. The change control workflow caught it within a week.
Audit Gates and Certification
Financial data gets audited monthly. Asset data should follow a similar rhythm, but most organizations only look at it during annual physical inventories — if then.
The Monthly Asset Data Certification Process:
Week 1: Automated Exception Reports Run reports on assets with missing mandatory data, assets with no maintenance history for 12+ months, assets with duplicate indicators (same serial, same location), and new assets created without proper approval.
Week 2: Steward Review Each steward reviews their area's exceptions, documents correction actions or valid reasons, and escalates systematic issues.
Week 3: Sampling Audit Random selection of around 5% of assets, physical verification against system records, photo updates for any discrepancies, and scoring based on accuracy.
Week 4: Certification Stewards certify their area's data quality, with roll-up reporting to site management and action items for systematic issues.
One mining operation found they were missing criticality ratings for 30% of their assets — but only in one specific area. Turned out a new supervisor didn't know the field was mandatory. A quick training session fixed what could have become a serious data quality issue.
The duplicate detection and merge protocol
Even with solid governance, duplicates will occasionally slip through. The key is catching and resolving them before they corrupt months of operational data.
Automated Duplicate Detection Rules
Level 1: Exact Match Detection
-
Same serial number, different asset ID
-
Same manufacturer + model + location
-
Same nameplate data across records
Level 2: Fuzzy Match Detection
-
Similar names with typos (PUMP-101 vs PMP-101)
-
Adjacent assets with identical attributes
-
Sequential serial numbers in same location
Level 3: Behavioral Detection
-
Multiple assets with identical PM schedules
-
Assets with no work history near assets with heavy history
-
New assets created within days of similar assets
A chemical plant's detection rules flagged 47 probable duplicates in their first run. Manual review confirmed 41 were actual duplicates, mostly created during a recent turnaround when contractors couldn't access the main system.
The Merge Decision Matrix
Not all duplicates should be merged immediately. Sometimes the duplicate exists for a reason that needs investigation first.
| Scenario | Detection Signal | Action Required | Approval Level |
|---|---|---|---|
| Exact serial match | Same S/N, different IDs | Immediate merge | Data Steward |
| Similar equipment | Same model, adjacent location | Investigate installation dates | Technical Owner |
| Parent/child confusion | Subcomponents listed as separate assets | Restructure hierarchy | Engineering + Finance |
| Cross-system duplicates | EAM vs ERP mismatch | Reconcile before merge | Finance Controller |
| Historical splits | One asset became two after modification | Maintain both with clear dates | Site Manager |
The Safe Merge Process
Pre-Merge Checklist:
-
Export all work order history from both records
-
Document all PM schedules and their last-done dates
-
List all spare parts links
-
Capture all warranty information
-
Screenshot both records for audit trail
Merge Execution:
-
Select primary record (usually oldest with most history)
-
Transfer all work orders to primary
-
Combine PM schedules (don't duplicate)
-
Merge spare parts lists
-
Preserve newest warranty data
-
Add merge note to asset comments
Post-Merge Validation:
-
Verify total work order count matches
-
Check PM schedule for duplicates
-
Confirm spare parts links work
-
Test any system integrations
-
Monitor for 30 days for issues
Merging duplicates incorrectly can lose years of maintenance history. Here's the process that preserves data integrity:
Building the technical infrastructure
The best governance framework falls apart without technical infrastructure to support it. Excel and email aren't sufficient for managing thousands of asset records across multiple sites and systems.
Master Data Management Architecture
Your asset data needs a single source of truth, but that doesn't mean one system. It means one authoritative record that other systems reference.
The Hub-and-Spoke Model:
EAM as the Hub:
-
Owns operational asset data
-
Masters maintenance history
-
Controls asset hierarchy
-
Manages technical specifications
Connected Spokes:
-
ERP
Financial data, depreciation, capital values
-
Historian
Operating parameters, runtime, performance
-
GIS
Location data, as-built drawings
-
Document Management
Manuals, certificates, photos
The key is defining which system owns which fields. The EAM might own the criticality rating, but the ERP owns the book value. Changes in the authoritative system trigger updates in others — not the other way around.
Data Quality Monitoring Dashboard
You can't manage what you don't measure. Asset data quality needs visible metrics that actually drive behavior.
Tier 1 Metrics (Daily Monitoring):
-
New assets created without approval
-
Duplicate detection alerts
-
Missing mandatory field count
-
Failed validation rules
Tier 2 Metrics (Weekly Monitoring):
-
Data completeness score by area
-
Approval workflow cycle time
-
Change request backlog
-
Physical verification results
Tier 3 Metrics (Monthly Monitoring):
-
Duplicate rate trending
-
Cross-system reconciliation rate
-
Audit finding counts
-
Data quality certification scores
A utility company started displaying these metrics on screens in their maintenance shops. Data quality became competitive between areas. Their duplicate rate dropped from around 12% to under 2% in eight months — mostly through visibility and peer pressure, not technical fixes.
Integration and Synchronization Rules
Systems need to talk without creating duplicates. That requires clear rules about data flow and update authority.
One-Way Sync Rules:
-
ERP → EAM
Capital values, depreciation rates
-
EAM → ERP
Asset status, retirement dates
-
EAM → Historian
Asset hierarchy, nameplate data
-
GIS → EAM
Location updates, spatial relationships
Conflict Resolution Protocol:
-
Authoritative system wins
-
Log the conflict for review
-
Alert data steward if critical field
-
Prevent cascade updates until resolved
Update Frequency Standards:
-
Critical fields
Real-time
-
Financial data
Daily
-
Technical specs
Weekly
-
Non-critical attributes
Monthly
This isn't about perfect synchronization. It's about preventing the slow drift that creates unfixable mismatches down the road.
Change management and adoption
The best framework means nothing if your organization doesn't follow it. And they won't follow it if it makes their job harder without clear benefit.
The Stakeholder Reality Check
Maintenance Technicians
-
Current pain
Can't find assets during breakdowns
-
What they need
Quick search, mobile access, photos
-
What they resist
Complex approval workflows
-
How to win them
Show how good data reduces rework
Operations Managers
-
Current pain
Unreliable performance metrics
-
What they need
Trustworthy KPIs, accurate costs
-
What they resist
Another approval in their inbox
-
How to win them
Show the insurance and audit benefits
Finance Team
-
Current pain
Asset reconciliation nightmares
-
What they need
Clean depreciation data, audit trails
-
What they resist
Learning "maintenance systems"
-
How to win them
Position this as financial controls
Engineering
-
Current pain
Incomplete technical specifications
-
What they need
Standardized data, change history
-
What they resist
Rigid naming conventions
-
How to win them
Give them ownership of standards
The Phased Rollout That Works
Phase 1: Stop the Bleeding (Months 1-2)
-
Implement duplicate detection
-
Add basic creation gates
-
Assign data stewards
-
Start monthly metrics
Focus only on preventing new problems. Don't try to fix historical data yet.
Phase 2: Build Momentum (Months 3-4)
-
Add change control workflows
-
Implement lifecycle states
-
Begin monthly audits
-
Clean up critical assets only
Show wins on high-visibility equipment before tackling everything.
Phase 3: Systematic Improvement (Months 5-6)
-
Roll out to all asset classes
-
Add integration rules
-
Implement merge protocols
-
Expand steward network
Phase 4: Sustained Operations (Months 7+)
-
Monthly certification process
-
Continuous improvement cycles
-
Annual framework reviews
-
Benchmark against other sites
A manufacturing company tried implementing everything in month one. Adoption failed completely. They reset, followed this phased approach, and achieved around 94% compliance within eight months.
Training That Actually Sticks
For Technicians: "Data That Helps You"
-
How to search effectively
-
Why photos matter
-
Quick duplicate checks
-
Mobile app shortcuts
Keep it under 30 minutes, focus on their daily pain points.
For Supervisors: "Data That Protects You"
-
Audit implications
-
Compliance requirements
-
Approval workflows
-
Exception reports
Connect data quality to their performance metrics.
For Managers: "Data That Pays Off"
-
Cost of duplicates
-
Insurance impacts
-
Capital planning benefits
-
ROI calculations
Show the money. A 10% reduction in duplicates might save $200K annually in unnecessary maintenance.
For Data Stewards: "Your New Superpower"
-
Deep dive on all processes
-
System administration
-
Report interpretation
-
Escalation procedures
Invest heavily here. Good stewards make everything else work.
Early warning signals and prevention
The best asset data governance framework catches problems before they cascade. Here are the early warning signals that your asset data is drifting toward chaos, and what to do about each one.
The Five Warning Signals
Signal 1: Work Order Orphans When maintenance teams start logging work orders against locations or generic equipment IDs instead of specific assets, you have a search problem. They can't find the right asset quickly enough. Prevention: Implement predictive search in your mobile CMMS. As they type, show photos and locations. Make finding the right asset faster than creating a wrong one.
Signal 2: The Excel Shadow System When departments maintain their own equipment lists in Excel "because the EAM data isn't reliable," you've lost trust in the system of record. Prevention: Monthly reconciliation meetings where each department validates their assets in the system. Fix discrepancies immediately, not during annual audits.
Signal 3: Project Team Islands When capital project teams create assets in isolation and hand them off to maintenance after commissioning, you get duplicates and incomplete records. Prevention: Require project teams to create assets in the EAM during the design phase, not after commissioning. Include the data steward in project gate reviews.
Signal 4: The Criticality Shuffle When asset criticality ratings keep changing based on who's asking or what budget is available, you've lost control of risk management. Prevention: Lock criticality changes behind a formal risk assessment process. Require documentation justifying any rating change.
Signal 5: Integration Breakdown When your EAM and ERP asset counts differ by more than 2%, integration rules have failed or weren't enforced. Prevention: Daily reconciliation reports with automatic escalation. Don't wait for month-end to discover mismatches.
The Prevention Scorecard
| Metric | Green | Yellow | Red | Action if Red |
|---|---|---|---|---|
| Assets created without approval | <1% | 1-5% | >5% | Lock creation rights |
| Duplicate detection rate | <2% | 2-5% | >5% | Mandatory retraining |
| Missing mandatory fields | <5% | 5-10% | >10% | Field audit required |
| Days since last physical verification | <30 | 30-60 | >60 | Schedule immediately |
| Cross-system variance | <1% | 1-3% | >3% | Integration review |
A food processing company uses this scorecard in their weekly ops review. When metrics hit yellow, the data steward gets resources to investigate. Red triggers escalation to site management.
Making it sustainable with operational software
Managing asset data governance manually is like trying to maintain equipment without a CMMS. You can do it with spreadsheets and paper forms, but it won't scale and it won't last.
Modern AI-powered operational software changes the equation. Instead of people manually checking for duplicates, the system detects them automatically. Instead of emails chasing approvals, workflows route on their own. Instead of monthly Excel reconciliations, dashboards update in real time.
Automated Duplicate Prevention AI algorithms detect potential duplicates before creation, not after. They learn from your naming patterns and flag suspicious entries. One manufacturer reduced duplicate creation by over 90% just by adding AI-powered duplicate detection to their asset creation screen.
Intelligent Data Validation The software learns what "good" data looks like for each asset class. It flags outliers — like a pump with a 50-year design life or a motor with zero nameplate capacity — instantly, not during annual audits.
Workflow Automation Approval routing based on asset value, criticality, and type happens automatically. The right person gets the right request without manual configuration. Escalation fires automatically when approvals lag.
Integration Intelligence Instead of rigid field mapping, AI-powered integration adapts to data patterns. It recognizes when the ERP calls something "Pump-101" and the EAM calls it "P-101" and maintains the link without creating duplicates.
Predictive Data Quality The system identifies data quality degradation before it becomes critical — noticing that assets in Building 5 have declining completeness scores and alerting the steward before the monthly audit surfaces the problem.
What matters most is that the software makes good data governance easier than bad practices. When finding the right asset is faster than creating a duplicate, people follow the process naturally.
Building organizational readiness
Even with solid technical solutions, asset data governance fails without organizational readiness. This isn't about change management posters and town halls — it's about aligning incentives and removing friction.
The Incentive Alignment Model
People do what they're measured on. If technicians are measured on work order closure speed, they'll create duplicates to close tickets faster. If managers are measured on PM compliance percentages, they'll ignore data quality to hit their numbers.
-
Include data quality scores in performance reviews
-
Reward teams that maintain clean asset records
-
Penalize departments that create ungoverned assets
-
Celebrate successful duplicate merges
A utility company added "asset data quality" as 10% of the maintenance supervisor's bonus calculation. Data quality scores improved around 40% in one year. Incentives matter more than policy documents.
The Resource Reality
Good data governance requires dedicated resources. Not huge teams, but focused attention. Organizations that succeed commit roughly:
-
0.5 FTE per 5,000 assets for data stewardship
-
0.25 FTE per site for local coordination
-
1 FTE centrally for framework management
-
Budget for quarterly training refreshers
This isn't overhead. It's insurance against the much larger costs of bad data.
Conclusion: Asset data is operational data
Your asset data governance framework isn't about perfection. It's about trust. Can operations trust that the asset they're looking at is the right one? Can finance trust the depreciation calculations? Can insurance auditors trust your asset values?
The framework components — ownership model, lifecycle rules, audit gates, change workflows — aren't bureaucracy. They're the operational foundation that lets your organization scale without losing control.
Start with the basics. Assign ownership. Add creation gates. Implement monthly audits. Build from there based on what breaks. Most importantly, treat asset data with the same respect you give financial data, because at the end of the day they're the same thing — the operational truth about your organization's ability to produce value.
The companies that get this right don't just have cleaner data. They have lower maintenance costs, fewer audit findings, accurate capital plans, and defensible insurance claims. They can answer a simple question like "How many pumps do we have?" without launching a three-month investigation.
Your maintenance team doesn't need perfect asset data. They need trustworthy asset data. This framework delivers that trust, systematically and sustainably. The question isn't whether you need asset data governance — it's how much bad data will cost you before you implement it.
